Manufacturing service decision

Production injection molding tooling

Production tooling is a program asset, not only a machined block of metal. Its architecture must support the submitted part, resin, demand pattern, quality plan, maintenance model and commercial controls. MakeNexa coordinates reviewed tooling and molding routes across its supplier network while keeping tool life, capacity, timing, price and performance specific to the quoted program.

  • CAD nowSTEP or native model under one revision
  • DrawingCritical dimensions, finish and notes
  • QuantityFirst order and any repeat context
  • MaterialGrade, condition or open alternatives
  • TimingTarget date or priority window

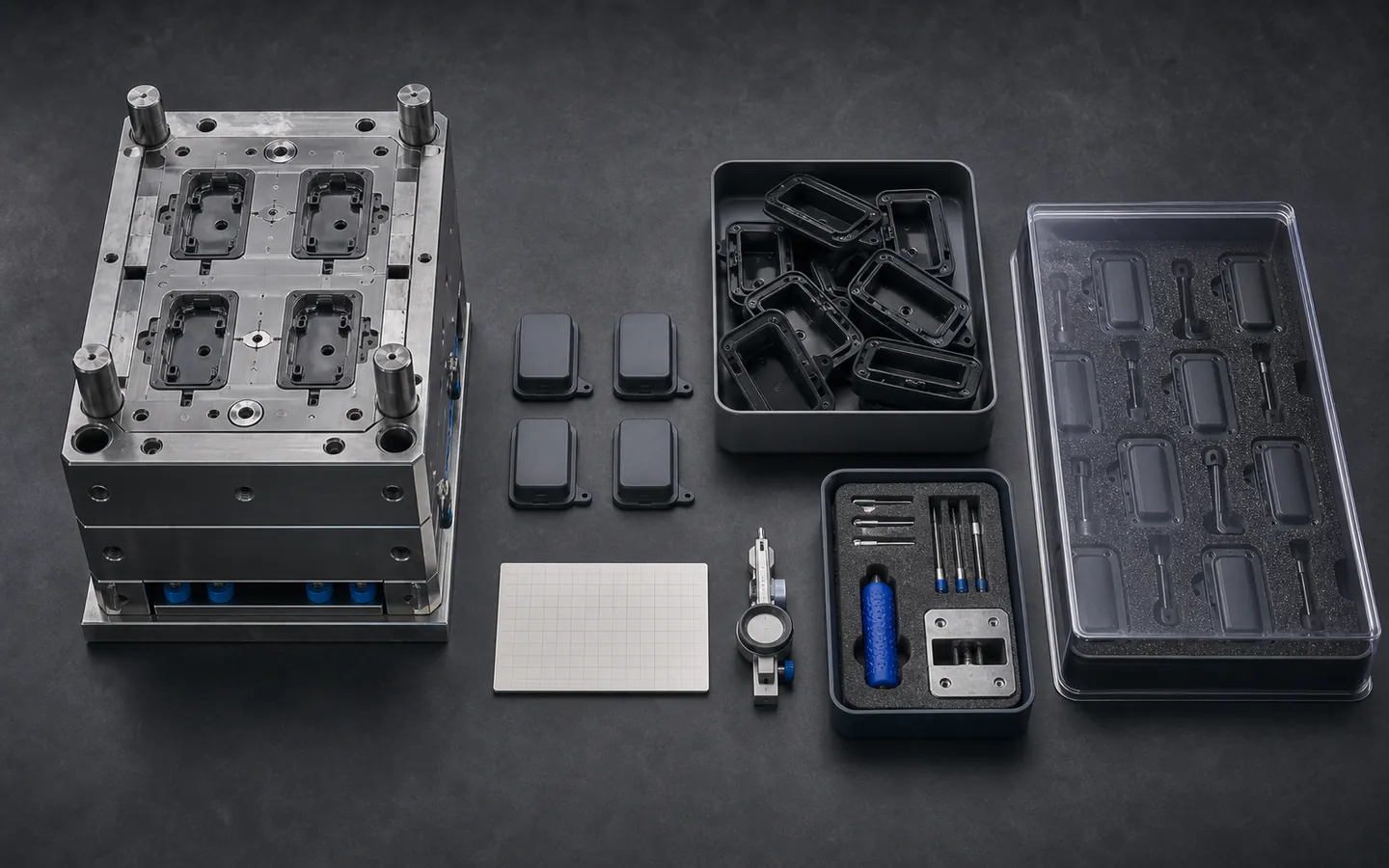

Four-cavity mold, matching molded housings, blank review grid, maintenance tools and protected repeat-part tray.
Ready to quote this part?Upload CAD for a reviewed quote across MakeNexa’s supplier network.
Get a Quote

Route decision

Commit to a production tool only after the operating assumptions are visible

Begin with demand and acceptance, then work backward to the tool. Annual volume alone is not enough: release size, forecast confidence, service-life expectation, resin availability, change risk, cosmetic controls, insert loading, secondary work and inspection influence cavity strategy and supplier fit. The goal is not the largest cavity count or most complex construction. It is a controlled route that can release acceptable parts, be maintained, and respond predictably when the design or demand changes.

A production-tool RFQ should combine the controlled part definition with resin, quantity bands, target release cadence, critical characteristics, appearance standards, sampling plan, packaging and ownership terms. Existing-tool programs also need tool records, condition, current location and a transfer review. MakeNexa evaluates the complete route and returns quote-specific clarifications; it does not infer assured mold life, cycle time, unattended production, universal capacity or future transfer compatibility.

Best-fit parts and programs

Build the tooling requirement around repeat releases

Production intent is demonstrated by controlled demand, quality and lifecycle decisions rather than a label on the purchase order.

Demand and cavity strategy

Provide realistic order bands, release frequency, forecast range and ramp assumptions. Cavity count must be considered with balance, part geometry, resin, quality, maintenance, capital, schedule and the consequences of one tool being unavailable.

Resin and part maturity

Freeze the intended resin grade, additives, color system, conditioning and substitution rules alongside the controlled geometry. A resin or revision change can affect shrink, flow, venting, cooling, wear and validated dimensions.

Sampling and release evidence

Define sample stages, dimensional scope, appearance review, functional assembly, process information and deviation handling. Separate tool acceptance from recurring part release so each decision has appropriate evidence.

Lifecycle and maintenance

Clarify preventive maintenance, consumable and insert responsibilities, repair authorization, storage, preservation, records and end-of-program disposition. These controls matter throughout the tool's service, not only at first sampling.

Feasibility checks

Expose program risks before construction begins

A late commercial or quality assumption can be as disruptive as a late geometry change.

Cavity count without demand context

More cavities can change balance, tool size, maintenance, sampling and the impact of a defect. Ask for the reasoning behind the proposed architecture and how it fits release size and forecast uncertainty.

Undefined final dimensions

Coatings, inserts, conditioning, assembly and measurement state can change acceptance. State which dimensions apply to as-molded, conditioned, finished or assembled parts and provide the measurement method where it matters.

Cosmetic intent carried by adjectives

Terms such as production quality or perfect finish are not acceptance criteria. Mark appearance zones, texture references, gate and ejector constraints, color method, viewing conditions and allowed variation.

Uncontrolled tool changes

Repairs and optimization changes can affect validated characteristics. Define authorization, revision records, resampling triggers and how changed components are identified before repeat parts are released.

Route options

Select a production route that matches program maturity

The proposal should make tradeoffs visible instead of treating one construction as universally correct.

Single-cavity or staged capacity

A simpler initial route may fit uncertain demand or complex validation, with additional tools or cavities added when requirements stabilize. Review supply continuity and qualification implications before choosing the staged plan.

Multi-cavity production route

A multi-cavity design can support established demand when balance, tooling complexity, inspection and maintenance are addressed. Define cavity identification and any cavity-specific sampling or traceability expectations.

Family or modular concept

Shared or replaceable tool elements may fit related parts, but coupling products can add scheduling, balance, change and maintenance dependencies. Use the concept only when those dependencies are acceptable and documented.

Decision comparison

Production tooling values used in review

Typical published practice for production injection tooling. Achievable tool life, cycle time and lead time depend on resin, geometry, cavity count and tool construction, and the project requirement is confirmed on the reviewed quote rather than from this table.

Program layerTypical published valueQuote or release output
Pre-hardened tool steelP20 at about 30 HRC, commonly rated for several hundred thousand shots in unfilled resinsThe default for moderate-volume production
Hardened tool steelH13 heat treated to roughly 48 to 52 HRC, commonly rated beyond a million shots and required for abrasive filled resinsHigh-volume programmes and glass-filled grades
Lead timeCommonly 8 to 16 weeks to first samples depending on cavity count and complexityWhere tooling sits in the programme schedule
Cavity countChosen from annual volume, cycle time and press tonnage rather than from a preferenceThe forecast stated as a forecast, not as a firm order
Cycle timeDominated by cooling, which follows the thickest wall section squaredWhy a 3 mm wall costs far more per part than a 2 mm one over a programme
Cooling layoutConformal or conventional water circuits designed with the tool, not added afterwardPart geometry that permits effective cooling
Hot runner against cold runnerHot runners remove sprue waste and shorten cycle at higher tool cost and complexityVolume, resin cost and colour-change frequency
Tool toleranceCut and inspected to tighter than the part tolerance, commonly ±0.02 mm on critical cavity dimensionsWhich part dimensions are critical, stated before the tool is cut
Shrinkage assumptionCut for one resin — about 0.5% for ABS against 2.5% for acetal, and much lower for filled gradesThe resin fixed before the tool is cut
Surface finish gradesStandard grades run from machined through progressively polished to textured, each specified rather than describedThe grade named on the drawing
Tool approvalFirst-article dimensional inspection plus process capability on critical characteristics, commonly a Cpk of 1.33What is measured, at what frequency, and against what
Maintenance and sparesWear components, spare cores and preventive maintenance intervals defined with ownershipWho owns, stores and maintains the tool
Part tolerance contextMoulded parts commonly hold ±0.1 mm on small features, with ±0.05 mm achievable where the tool and process are controlled for itWhich part dimensions the tool must be cut to reach
Wall thickness leverReducing a 3 mm nominal wall to 2.0 mm cuts cooling time substantially, and cooling dominates cycleDesign changes made before the tool is cut, not after
Minimum wall1.0 mm is about the practical floor for most unfilled thermoplastics over any distanceWhether the design fills at all
Melt temperature by resinCommonly 250 °C for ABS and up to 320 °C for polycarbonate; hot-runner systems must be specified for the resinThe resin fixed before the tool is designed
Polished tool surfaceA polished cavity produces part surfaces near Ra 0.4 µm; a machined cavity leaves visible tool marks on the partThe finish grade named on the drawing

Quote inputs

Production injection tooling RFQ checklist

Package the tool, molded part and repeat-order requirements as one controlled program.

Complete packages move faster: revision-matched CAD, critical dimensions, quantity and material notes are enough to open engineering review across the network.

Get a Quote
  1. 01

    Provide the released 3D model, drawing, revision history and remaining design risks

  2. 02

    State resin grade, additives, color, conditioning, substitution limits and supplied-material requirements

  3. 03

    Provide order quantities, release cadence, forecast range, ramp and continuity expectations

  4. 04

    Define critical dimensions, appearance zones, assembly checks, tests and sample approval stages

  5. 05

    List inserts, secondary operations, marking, inspection records, packaging and cavity-identification needs

  6. 06

    Set ownership, payment, maintenance, repairs, change authorization, storage, transfer and end-of-program expectations

Questions before routing

Questions about this manufacturing route

These answers prepare the request; the reviewed quote controls project-specific commitments.

How many cavities should a production injection mold have?

It follows from annual volume, cycle time and available press tonnage rather than from a preference. More cavities cut per-part cycle cost and raise tool cost, tool complexity and the consequences of any single-cavity problem — a defect in one cavity of an eight-cavity tool affects an eighth of production until it is corrected. State the annual forecast, distinguished clearly from firm order quantity, so the trade can be evaluated.

What does production tool ownership include?

It needs defining rather than assuming, and it covers more than title. Storage, preventive maintenance intervals, wear-component replacement, spare cores, the right to move the tool to another supplier, the tool's condition on transfer, and end-of-programme disposition are all separate questions. A tool rated beyond a million shots outlives most supplier relationships, so state the expectation in the RFQ.

How is a production mold approved?

By a stated qualification rather than by first-part appearance. The usual scope is a first-article dimensional inspection against the drawing's critical characteristics, process capability on those characteristics with a target commonly stated as a Cpk of 1.33, and functional or cosmetic acceptance against a reference. Name the critical characteristics before the tool is cut, because the tool is cut tighter than the part tolerance to reach them.

How many shots does a production injection mold last?

P20 at about 30 HRC is commonly rated for several hundred thousand shots in unfilled resins, and H13 heat treated to roughly 48 to 52 HRC beyond a million — both route through the network, along with hot-runner systems and multi-cavity tooling. Three things move the figure for a specific tool: resin abrasiveness, since glass-filled grades wear tooling far faster than unfilled; geometry, since thin steel and small side actions wear first; and maintenance practice. State the resin, annual volume and expected programme life and the tool construction, cavity count and rated life are matched to them on the reviewed quote.

What drives production molding cost per part over a programme?

Cycle time, and cycle time is dominated by cooling — which scales with the square of the thickest wall section. That makes wall thickness the largest lever available: reducing a 3 mm nominal wall to 2 mm can cut cooling time substantially across every shot for the life of the tool. Resin cost, cavity count, sprue waste on a cold runner and scrap rate follow. These are design decisions, and they are cheapest to make before the tool is cut.
