Prototype to production manufacturing guide

A prototype proves a question; production must reproduce an accepted result through a controlled route. This stage-gate guide helps buyers decide what has been learned, what must be frozen, which tooling and evidence are justified, and how changes will be handled before repeat orders begin.

  • CAD nowSTEP or native model under one revision
  • DrawingCritical dimensions, finish and notes
  • QuantityFirst order and any repeat context
  • MaterialGrade, condition or open alternatives
  • TimingTarget date or priority window

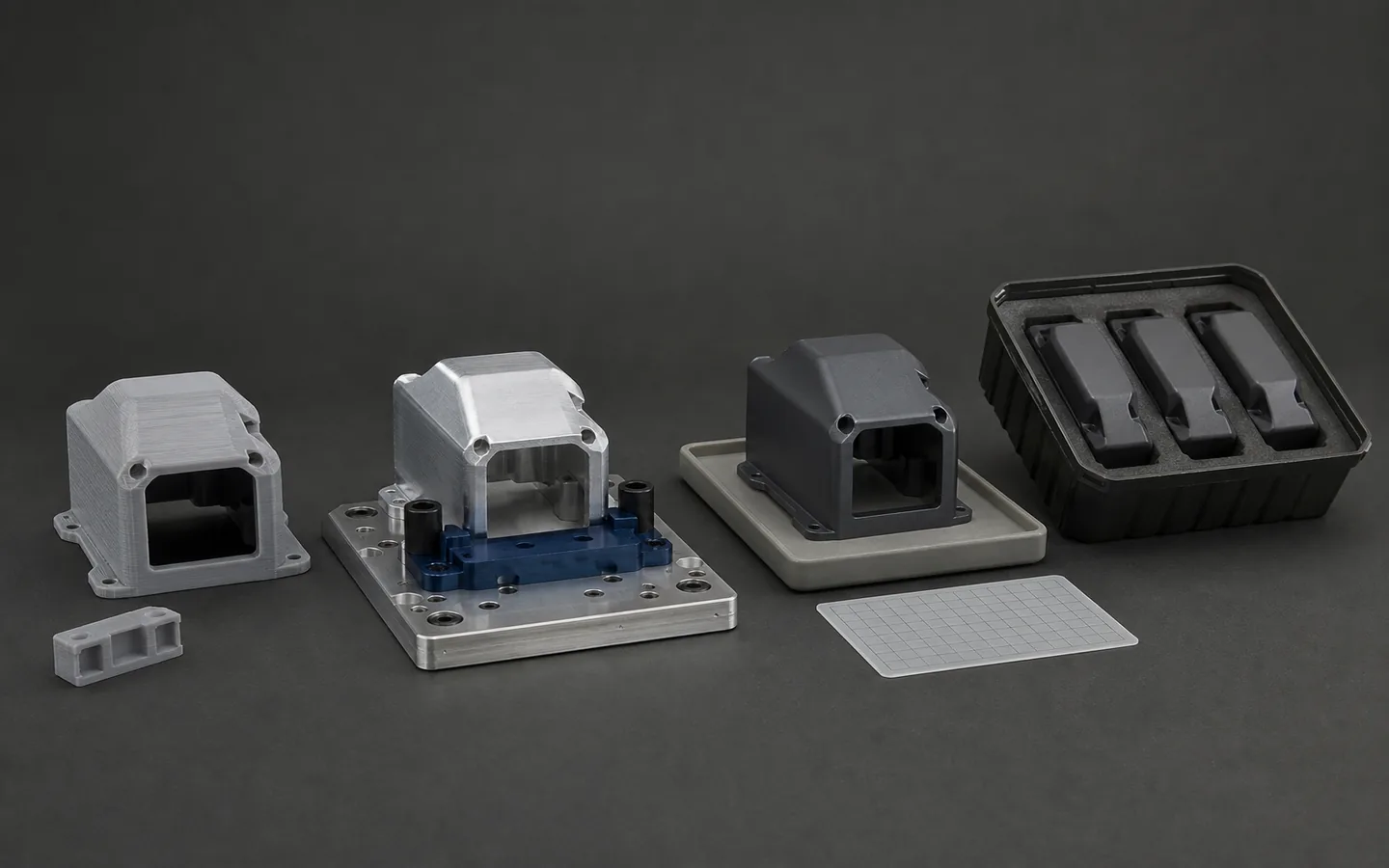

Matching housing moves from layered prototype through fixture-mounted pilot and finished sample to three packaged repeat parts.
Ready to quote this part?Upload CAD for a reviewed quote across MakeNexa’s supplier network.
Get a Quote

Use this guide

Convert prototype learning into a controlled production definition

Begin by writing down what each build actually validated. A form model may establish envelope and ergonomics without proving final material behavior. A functional prototype may test interfaces but use a different process, finish or inspection plan. A production-intent pilot should bring the material, route, tooling, secondary operations, acceptance evidence and packaging closer to the repeat condition. Do not let the word prototype hide which requirements remain untested or which substitutions were temporary.

Production readiness also needs commercial and operational context: expected quantity, release cadence, revision horizon, replacement demand, packaging, destination and record retention. These inputs determine whether dedicated fixtures, tools, first-article work or supply commitments make sense. MakeNexa can review the current package and route alternatives through its supplier network, but transition time, capacity, repeatability, tooling strategy and approval evidence remain project-specific rather than assured by this guide.

Design priorities

Use evidence-based gates between build stages

Advance the route only when the prior build answered its intended question and the next risk is explicitly defined.

Learning prototype

Define the question being tested: size, movement, assembly, appearance, thermal behavior or another use condition. Record temporary material, process and finish departures so they are not mistaken for the production definition.

Production-intent pilot

Use the planned material condition, geometry authority, key secondary operations and representative acceptance methods where feasible. Confirm that assembly, handling and packaging expose no new failure mode.

First controlled release

Agree the sample, drawing characteristics, process condition, material evidence, report format and deviation path before work begins. Approval should identify exactly which revision and route may proceed.

Repeat production

Maintain revision, approved deviations, supplier route, tooling status, inspection scope, lot linkage and packaging instructions. Define which changes require notification, re-review or a new first article.

Common review gaps

Transition gaps that turn into repeat-production risk

A successful prototype can still leave material, process and control assumptions unresolved.

Prototype route treated as permanent

Machining, printing, casting, fabrication or soft tooling may be ideal for learning but not for the planned quantity or final properties. Revisit the route when demand, geometry maturity or evidence requirements change.

Revision freeze without decision history

A frozen filename is not enough if temporary waivers, rework, hand fitting or assembly selection made the prototype succeed. Convert those observations into controlled requirements, approved deviations or design changes.

Quality plan added after tooling

Datums, gauge access, destructive tests, cosmetic zones and sample scope can affect fixtures, tooling and sequence. Define acceptance before committing to a route that prevents the required evidence.

Packaging excluded from validation

Finished parts can be damaged, mixed, contaminated or lose traceability after manufacture. Validate orientation, protection, labels, lot separation and storage for the real shipping and receiving path.

Practical choices

Choose the next investment from demand and risk

Tooling and controls should answer a real repeat-production need rather than serve as proof of maturity by themselves.

Flexible bridge route

Keep a lower-commitment route when geometry may still change, demand is uncertain or market learning matters more than unit optimization. Define which performance differences from the future route are acceptable.

Dedicated production route

Consider fixtures, hard tooling, committed stock or specialized controls when the definition and cadence are stable enough to justify them. Record ownership, maintenance, life, storage and change implications.

Dual-stage qualification

Use a pilot to validate process and assembly, followed by a formally scoped first article before broad release. This separates learning changes from the evidence used to approve repeat production.

Design decision table

Stage transitions and the values that change at each

Typical published practice at each stage of a manufacturing programme. Where a specific part sits depends on its geometry, material and quantity, and the project requirement is confirmed on the reviewed quote rather than from this table.

StageTypical published valueControlled output
Form and fit, 1 to 5 partsFDM at ±0.2 mm or ±0.2%; SLA at ±0.1 mm or ±0.1%, in daysWhether the geometry is right
Functional test, 1 to 20 partsCNC at ±0.125 mm in the production material, or SLS and MJF at ±0.3 mm in PA12 at about 48 MPaWhether the design works in a representative material
Engineering build, 20 to 100 partsMachining, or urethane casting at ±0.2 mm with silicone moulds lasting 20 to 25 partsWhether the design assembles and survives use
Pilot, 100 to 10,000 partsAluminium injection tooling at 1,000 to 10,000 shots, 2 to 4 weeks to samples; or CNC with fixturingWhether the process is repeatable
Production, above 10,000P20 tooling at about 30 HRC for several hundred thousand shots, 8 to 16 weeksWhether the process is capable and controlled
What changes in the drawingCritical characteristics named, capability target stated — commonly a Cpk of 1.33 — and material specification fixedThe controlled definition for repeat supply
What changes in inspectionFrom a first-article report on one part to stated-frequency measurement and sampling, commonly drawn to ANSI Z1.4Proportionate ongoing evidence
What changes in workholdingFrom soft jaws at roughly ±0.05 mm to dedicated fixtures repeating within about 0.01 to 0.02 mmRepeatability across batches
What does not transferA printed part's 30 to 70% interlayer strength, a prototype tool's shrinkage, a hand-formed sheet part's ±0.5 mmWhich conclusions each stage supports
Design rules that persistUniform wall 1.0 mm to 3.0 mm, draft 1° to 2°, machined radii above 1 mm, pocket depth under about 4 times cutter diameterDesigned in early or paid for later
Revision controlA controlled revision identifier from the first prototype, with change authority at productionNo change inferred from a replaced file
Material controlFrom whatever stock is available to a specified grade, temper and specification with certification per lotTraceability scope defined

Turn the guide into an RFQ

Production-transition RFQ checklist

Send the current evidence and the intended production context so engineering can distinguish proven requirements from open assumptions.

Complete packages move faster: revision-matched CAD, critical dimensions, quantity and material notes are enough to open engineering review across the network.

Get a Quote
  1. 01

    Identify what each prototype build validated and every temporary material, process, finish or rework departure

  2. 02

    Provide the current controlled model, drawing, bill of materials and approved deviation history

  3. 03

    State expected quantity bands, release cadence, destinations, service horizon and revision outlook

  4. 04

    Define intended tooling or fixture ownership, maintenance, storage and change constraints where applicable

  5. 05

    Specify critical characteristics, material records, sample plan, first-article scope and approval responsibility

  6. 06

    Describe assembly, labeling, preservation, packaging, logistics and triggers for production re-review

Questions before routing

Questions when applying this guide

These answers prepare the request; the reviewed quote controls project-specific commitments.

When is a prototype ready for production?

When the questions it was built to answer have been answered and the definition is controlled. Practically that means the geometry is stable, the critical characteristics are named with achievable tolerances, the material is fixed with grade and condition, the finishing sequence is decided, and a controlled revision exists. If the prototype was printed or made in a substitute material, one more build in the production process is usually needed before committing to tooling.

Should the production process match the prototype process?

Not necessarily, but the differences have to be understood before they surprise you. A printed prototype carries interlayer strength at only 30 to 70% of its in-plane value; a machined one has no knit lines or moulded-in stress; only a moulded part behaves like a moulded part, with shrinkage from about 0.5% for ABS to 2.5% for acetal. Where the production process differs, plan a qualification build rather than assuming the prototype's results transfer.

Do I need a first article before repeat orders?

Before repeat production begins, yes — it establishes that the process produced a correct part under controlled conditions at a stated revision, measured in the delivered condition. It should be re-triggered by a design revision, a process or tooling change, a supplier change or a long production gap. What it does not do is evidence that later parts will match: that comes from the sampling plan and capability control defined alongside it.

How long does it take to scale from prototype to production?

The schedule is usually set by two items rather than by machining capacity: tooling, at commonly 2 to 4 weeks for aluminium injection tooling and 8 to 16 weeks for production steel, and material availability for specified grades, tempers and AMS-referenced stock. Fixturing, capability demonstration at a target such as a Cpk of 1.33, and first-article approval add their own time on top. All of it routes through the network in parallel where the programme allows. State the volume ramp and the target date and a schedule against real lead times comes back on the reviewed quote.

What should be decided before committing to tooling?

The resin or material, because the tool is cut for one of them — shrinkage runs from about 0.5% for ABS to 2.5% for acetal and a change means a new tool. Then the wall thickness, since cooling dominates cycle and scales with the square of the thickest section, so a 3 mm wall costs more than a 2.0 mm one on every shot for the tool's life. Then draft, undercuts, cosmetic surfaces and where gate and ejector marks may land.
